Continuous Transformer Condition Data & ISO 55001:2024

Continuous Transformer Condition Data & ISO 55001:2024

‍

Which clauses of ISO 55001:2024 continuous condition data can supply, what remains the customer's own to satisfy, and the value case in capital terms.

Rahul Chaturvedi
Founder & CEO
Contents

Predictive action now has a clause number.

Executive Summary

ISO 55001:2024 is not a cosmetic revision of the 2014 edition. It adds a required framework for asset management decision-making, rewrites the data and information requirements, and renames preventive action to predictive action with a full technical revision of that subclause. Organizations certified to the 2014 edition must complete a 2024 certification audit before 31 July 2027.

For a transformer fleet, the three changed areas all resolve to the same question: can you state, with evidence, what a specific unit will do next and why you believe it. This paper maps the clauses of ISO 55001:2024 that continuous condition data can supply, states plainly what remains the customer's own to satisfy, and shows the value case in capital terms.

An asset management system is a decision framework. ISO 55001:2024 makes that explicit in a way the 2014 edition did not, by adding Clause 4.5, which requires a documented framework for asset management decision-making, defined decision criteria, and appropriate methods, processes and tools to support those decisions.

Three of the 2024 changes bear directly on transformer fleets:

Clause 10.3 replaces preventive action with predictive action. It requires processes that predict the future behavior of a parameter needed to support a decision, so the organization can anticipate what is coming and determine optimal intervention points. Age is not a predicted parameter. It is a proxy.

Clause 7.6 replaces the former information requirements clause with data and information. It requires documented specifications covering data attributes, quality, and sources, and traceability between financial and non-financial data.

Clause 8.1 now states explicitly that operational planning and control includes life cycle management across creation, acquisition, utilization, maintenance, improvement, renewal, and disposal.

Continuous condition data does not make an organization conformant. It supplies the measured parameter that Clause 10.3 asks the organization to predict, the traceable criteria Clause 4.5.2 asks it to define, and the specified data Clause 7.6 asks it to document. The governance around those inputs remains the organization's own work.

This paper is written for asset management managers, reliability engineers, and internal auditors preparing a 2024 transition. Section 12 contains the full clause map. Appendix A is an evidence checklist you can take into a gap analysis.

Why the 2024 edition changes the argument

The 2014 edition was permissive about data. It required an organization to determine the information it needed and to keep it. It did not require the organization to say what good data looks like, how a decision gets made, or how a future condition gets predicted. Ten years of implementation exposed the gap. Decision frameworks were informal. Condition data was thin and disconnected from the plans it was supposed to inform.

The second edition closes that gap with specific requirements. The following changes matter most to an organization managing power or distribution transformers.

Clause (2024) What Changed Why It Matters for a Transformer Fleet
4.5 New. A framework for asset management decision-making, defined decision criteria, and selected methods, processes and tools. The basis for calling a unit high risk now has to be written down and defended. A rating with no traceable derivation is an audit finding.
6.1.2 / 6.1.3 Risk and opportunity separated into distinct subclauses, with the risk assessment process specified in more detail. Remaining life on a healthy unit is an opportunity, not just an absence of risk. It now needs its own treatment and its own evidence.
6.2.1 New. The Strategic Asset Management Plan becomes a distinct required artifact with specified content. The SAMP's transformer replacement strategy rests on a fleet condition baseline. Age distribution alone is a weak foundation for a document at this level.
7.6 Revised and renamed from information requirements to data and information. Data specifications, attributes, quality, sources, and financial to non-financial traceability. A monitoring system now has to arrive with a data specification, not just a dashboard. Sampling rate, units, uncertainty, and provenance become documentation.
7.7 New. Determine, retain, and keep current the knowledge needed to operate the asset management system. Failure mode judgment held only in individual engineers is a knowledge risk under this clause, and a live one given workforce turnover.
8.1 Revised. Operational planning and control explicitly covers life cycle processes and the treatment of risks identified under 6.1. Every life cycle gate becomes a decision point that condition data can inform: how hard to load, when to inspect, when to renew, when to retire.
8.3 Renamed from outsourcing to externally provided processes, products, technologies and services. A monitoring vendor is now explicitly something the organization must control and evidence, which changes what a vendor should hand over at procurement.
10.3 New. Predictive action replaces preventive action, fully rewritten. This is the clause a condition monitoring program exists to satisfy. It is also the clause a calendar-based inspection program cannot satisfy.

The transition deadline is a date, not a theme. Certified organizations must complete a 2024 audit before 31 July 2027. Every gap analysis being written now is being written against these clause numbers.

Clause 10.3: predictive action

Clause 10.3 replaces the 2014 subclause on preventive action. Read on its own terms, it requires the organization to establish processes for predictive actions, meaning actions that predict the future behavior of a parameter required to support decision-making, so that it can better anticipate future occurrences and impacts of nonconformities and opportunities, and determine optimal intervention points.

Three phrases in that requirement do real work.

A parameter

Not a category, not a score, not a bucket. A parameter is a measurable quantity with a unit and a value. Vibration amplitude at a defined frequency is a parameter. Winding hot spot temperature is a parameter. Asset class is not. Manufacture year is not.

Future behavior

Prediction requires a trajectory, which requires history at sufficient resolution to establish a rate of change. An inspection every one to five years produces a sequence of unrelated snapshots. It can confirm a condition already present. It cannot produce a rate.

Optimal intervention points

Optimality implies a defensible objective function. Intervening earlier than necessary consumes capital that had remaining life available. Intervening later risks the failure. Locating the point between them requires knowing how much life remains and how fast it is being consumed.

A calendar-based program cannot satisfy Clause 10.3, because the interval is set before any parameter is measured. The interval is an assumption about the population. Clause 10.3 asks about the asset.

What Clause 10.3 asks a transformer fleet operator to produce is therefore specific: a parameter measured on each unit, a history dense enough to establish its trajectory, a stated relationship between that parameter and a physical degradation mechanism, and an intervention threshold derived from that relationship rather than from convention.

Clause 4.5: decision criteria and the line of sight

Clause 4.5 is the largest structural addition in the 2024 edition. It strengthens the alignment of asset management from the strategic level to the operational level, the concept the discipline calls line of sight, and it requires consistent decision-making aimed at realizing value from assets. It has three parts: a framework for decision-making (4.5.1), the criteria to be used (4.5.2), and appropriate methods, processes and tools (4.5.3).

Line of sight runs downward. Organizational objectives inform the SAMP. The SAMP informs asset management objectives. Those objectives inform asset management plans. The plans inform activity on individual assets. Each link is supposed to be traceable to the one above it.

For most transformer fleets the line of sight is intact at the top and broken at the bottom. The SAMP states a reliability objective. The replacement plan states a number of units per year. The selection of which units is made on age, nameplate, and the recollection of whoever last visited the substation. There is no measured input at the point where the plan meets the asset, so the traceability that Clause 4.5 requires terminates one level above the decision it is meant to govern.

What 4.5.2 does to a risk rating

Clause 4.5.2 requires the organization to define the criteria used in asset management decisions. In an audit, that turns a severity rating into a claim that has to be substantiated. The auditor's question is short: this unit is rated high risk. On what basis?

A rating derived from a population baseline cannot answer it well. The honest answer is that the unit's signature differs from the signatures of other units in a reference set, by a margin someone chose. That answer invites three follow-up questions the organization usually cannot close: which units are in the reference set, why is that set representative of this unit, and what threshold was applied and who set it.

A rating derived from a physics-based model of the specific unit answers differently. The signal was measured. The signal maps to a mechanism. The mechanism drives a known failure mode. The severity follows from how far the mechanism has progressed. Each link is stateable, and each link is checkable by someone who was not in the room when the rating was produced.

Defensibility is a physics problem

The distinction in the previous section is not a matter of presentation. It follows from how the model is built. A worked example makes it concrete.

Worked example: loss of winding clamping pressure

Load current through a transformer winding produces Lorentz forces on the conductors. Force scales with the square of current, and squaring a sinusoid at power frequency produces a constant term plus a component at twice that frequency. On a 60 Hz system the winding is therefore driven mechanically at 120 Hz. The core contributes at the same frequency and its harmonics through magnetostriction, the dimensional change of the core steel under a varying magnetic field.

Clamping pressure holds the winding block in compression. As pressure relaxes through thermal cycling, short circuit events, and insulation shrinkage, the mechanical stiffness of the block falls. Falling stiffness lowers the natural frequencies of the structure. As those frequencies move toward the driving harmonics, the amplitude at those harmonics rises and the distribution of energy across the harmonic series changes shape. Triaxial accelerometers on the tank wall observe that change.

Amplitude alone is not diagnostic, because it also rises with load and falls with oil temperature as viscosity changes. This is where the model matters. VIE normalizes the observed response against the unit's own measured load, thermal state, and ambient conditions, using a virtual model built from that transformer's construction rather than a baseline learned from a population of other units. Magnetic field measurement separates core excitation from load-driven winding response. Local weather data closes the ambient term.

Link Statement an Auditor Can Check
Signal Triaxial vibration at the tank wall, harmonic content referenced to twice power frequency, sampled continuously.
Normalization Response corrected for measured load current, top oil and estimated winding temperature, and ambient conditions at the site.
Mechanism Reduced clamping pressure lowers winding block stiffness, shifting natural frequencies and redistributing harmonic energy.
Failure mode Loss of short circuit withstand capability. A unit with relaxed clamping can survive normal service and fail on the next through fault.
Severity Derived from the magnitude and rate of the frequency shift against the unit's own commissioning reference, not against a peer group.
Action Intervention threshold set where the projected trajectory reaches the point at which withstand margin is no longer defensible.

The reason this matters under Clause 4.5.2 is that a clean reading becomes affirmative evidence, not merely an absence of an alarm. If the model predicts the response of a healthy unit at a given load and temperature, and the measurement matches the prediction, the organization has positive evidence of health it can put in front of an auditor. A population-baseline system that produces no alarm has only established that nothing looked unusual.

Clauses 7.6 and 7.7: data, information, and knowledge

7.6 Data and information

The 2024 edition rewrote this clause. It now distinguishes data from information in an asset management context and requires documented specifications covering data attributes, quality, and sources, with alignment and traceability between financial and non-financial data.

The practical consequence is that a monitoring deployment has to arrive with documentation, not just an interface. For each measured quantity the organization needs the unit, the sampling interval, the measurement uncertainty, the sensor location and its provenance, the retention period, and the identifier that links the reading to a specific transformer in the asset register. VIE supplies that specification as a document per deployment, which becomes part of the customer's Clause 7.6 evidence rather than something they have to reconstruct.

The financial traceability requirement is the harder half, and it is the customer's. A condition record supports a replacement decision, that decision produces a capital entry, and the clause asks that the two be traceable to each other. That link is made in the customer's asset register and financial system, using the asset identifier VIE carries on every reading.

7.7 Knowledge

This subclause is new. It requires the organization to determine the knowledge needed to operate the asset management system, retain it, keep it current, and handle knowledge that has gone out of date.

For most transformer fleets the binding knowledge risk is people. The judgment that connects an observation to a likely mechanism often sits with a small number of long-tenured engineers and leaves when they do. A physics-based model is one way to hold part of that knowledge in a form the organization retains. The model encodes the relationship between measured signal and physical mechanism explicitly, which means it can be documented, reviewed, and taught. That is a legitimate 7.7 argument, and it is worth making carefully rather than overstating: a model holds the mechanism, not the operational judgment about what to do next.

Clauses 8.1 and 8.3: life cycle and external provision

8.1 Operational planning and control including life cycle management

The revised clause states explicitly that operational planning and control covers life cycle processes: creation, acquisition, utilization, maintenance, improvement, renewal, and disposal. It also states that treating the risks and implementing the opportunities identified under Clause 6.1 is an integral part of operational planning and control.

Condition data has a role at four of those gates. Utilization: how hard a specific unit can be loaded, given its measured mechanical and thermal condition rather than its nameplate. Maintenance: whether an inspection is warranted now. Improvement: whether a repair restores enough margin to justify the outage. Renewal: where the unit sits in the replacement sequence. The gates are the same ones the fleet already manages. The clause asks that the decision at each one be planned and controlled rather than inherited from a schedule.

8.3 Externally provided processes, products, technologies and services

The 2014 clause on outsourcing became, in 2024, externally provided processes, products, technologies and services. The requirements did not change substantially, but the wording puts a monitoring vendor unambiguously inside the scope of things the organization must control and evidence.

That works in a customer's favor if the vendor supplies what the clause needs. For a VIE deployment, the artifacts a customer needs under 8.3 are the scope of the externally provided service, the performance requirements against which VIE is evaluated, the data specification referenced in Clause 7.6, and the interface control document for the REST API. VIE supplies these at deployment. Requesting them from any monitoring vendor is a reasonable procurement test, and a vendor that cannot produce them is creating a Clause 8.3 gap for the customer to close later.

Clause 4: climate change is now in scope

The Harmonized Structure amendment applied across ISO management system standards requires an organization to determine whether climate change is a relevant issue in its context, and to consider relevant stakeholder requirements related to it. ISO 55001:2024 carries that requirement in Clause 4.

For a transformer fleet the determination is not difficult to make. Insulation aging follows an Arrhenius relationship, so the rate of life consumption is exponential in winding temperature, and winding temperature tracks ambient. IEEE C57.91 already provides the model. What has changed is the input distribution: higher summer ambient temperatures and longer sustained heat events shift a fleet's thermal duty upward, and the same load profile consumes life faster than the loading study assumed.

There is a second-order effect worth stating because it compounds the first. Long lead times for new transformers push operators to load existing units harder rather than add capacity. Harder loading raises winding temperature. Higher temperature accelerates Arrhenius aging. Accelerated aging brings end of life forward across the fleet at the same time, which increases replacement demand and extends lead times further. The loop tightens itself.

Under Clause 4 this is now a documented context issue rather than an operational complaint. An organization that has determined climate change is relevant needs some measure of the effect. Measured thermal duty per unit, trended, is that measure.

Where ISO 55001 sits relative to the transformer standards

ISO 55001 is a management system standard. It governs how decisions get made and evidenced. It does not tell an engineer what to measure on a transformer, what to call a failure, or how to convert temperature into consumed life. Three other standards do that work, and a condition data source has to serve all four layers to be usable inside an audited asset management system.

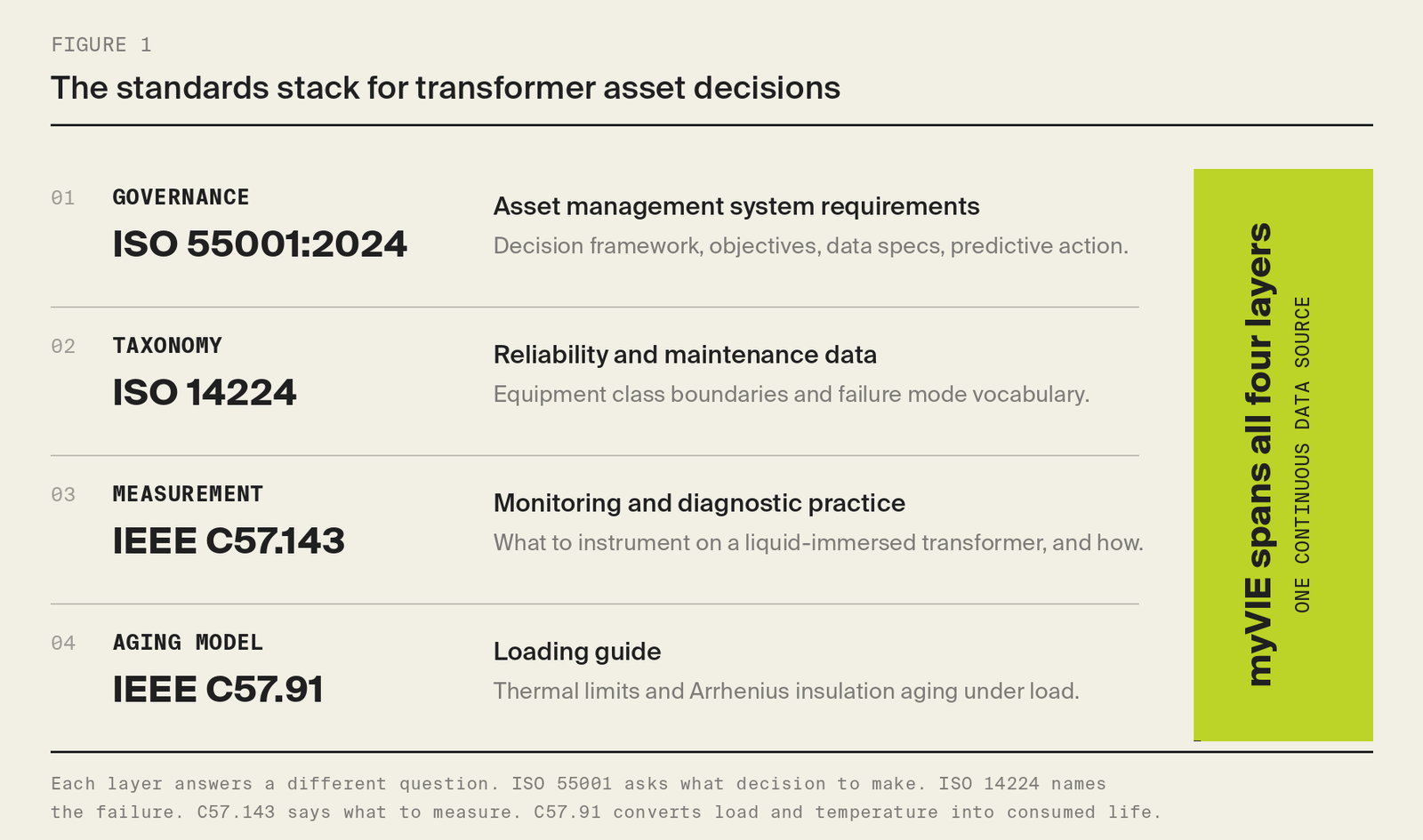

Figure 1. The standards stack for transformer asset decisions. Each layer answers a different question. ISO 55001 asks what decision to make. ISO 14224 names the failure. C57.143 says what to measure. C57.91 converts load and temperature into consumed life.

The layers are not interchangeable. An organization can hold ISO 55001 certification with a transformer program that measures nothing, because the standard does not prescribe instrumentation. Equally, a monitoring deployment that produces excellent measurements but cannot express its output in ISO 14224 failure mode vocabulary, or connect it to a C57.91 aging calculation, gives the asset management system a dashboard rather than evidence.

The value case in capital terms

ISO 55001 states its own purpose as realizing value from assets. A conformance argument that never reaches a number is incomplete. The mechanism through which continuous condition data produces value in a transformer fleet is resequencing: capital moves later on units with remaining life, and earlier on units without it.

The following worked example uses stated assumptions. Substitute fleet-specific values.

Assumption or Result Value
Fleet size, liquid-immersed power transformers, 10 to 50 MVA 238
Age-based replacement trigger in the current plan 55 years
Units crossing the trigger within the next five years 34
Replacement cost per unit, equipment plus installation $1.4M
Units at the trigger with no developing condition, resequenced four years later 19
Units below the trigger with a developing condition, moved forward three years 3
Weighted average cost of capital 7.2%
Capital deferred four years (19 units) $26.6M
Present value benefit of the deferral $6.46M
Present value cost of the three acceleration decisions $0.79M
Net present value of resequencing $5.67M

Two features of this example matter more than the total. First, it moves capital in both directions. A model that only ever recommends deferral is a cost avoidance tool that an auditor and a regulator will both discount. Second, the largest line is excluded. Avoided failure cost is real and usually dominates, but it is estimated rather than measured, so it does not belong in the number a capital committee is asked to approve.

For a rate-regulated utility there is a further consideration. A replacement program justified by measured condition is easier to defend on prudence grounds than one justified by age, because the record shows the specific evidence behind each unit's inclusion. The Clause 4.5.2 documentation the standard now requires is the same documentation a prudence review asks for.

Clause map

The table below maps ISO 55001:2024 clauses to the evidence continuous condition data can supply. Clause numbering follows the second edition.

Clause What the Standard Requires What VIE Contributes
4.1 / 4.2 Determine relevant internal and external issues, including whether climate change is relevant, and the stakeholder requirements to be addressed. Measured thermal duty per unit, trended against ambient, gives the organization a quantitative basis for its climate relevance determination and for stakeholder reporting on it.
4.5.2 Define the criteria to be used in asset management decision-making. Severity derives from a stated physical mechanism with a traceable chain from measured signal to failure mode, so the criterion behind a rating can be written down and checked.
4.5.3 Determine appropriate methods, processes and tools to support decision-making. VIE is a decision-support tool under this subclause, supplying condition and trajectory inputs at the asset level.
6.1.2 Address risks that could affect the ability to achieve asset management objectives, with a specified risk assessment process. Continuous failure mode and severity data replaces age as the likelihood input to the transformer risk assessment.
6.1.3 Address opportunities as a distinct process from risk. Identifies units with remaining life whose replacement can be resequenced, which is the opportunity side of the same assessment.
6.2.1 Develop a Strategic Asset Management Plan with specified content and alignment to organizational objectives. Supplies the fleet condition baseline and severity distribution the transformer intervention strategy in the SAMP rests on.
6.2.2 / 6.2.3 Establish measurable asset management objectives and plan and resource their achievement. Provides the continuous measurement stream that makes an objective such as reducing unplanned transformer outages trackable rather than assessed after the fact.
7.6 Maintain data and information specifications covering attributes, quality and sources, with financial to non-financial traceability. Every reading is timestamped and attributable to a specific transformer and sensor. VIE supplies the data specification per deployment. Financial traceability is completed in the customer's asset register.
7.7 Determine, retain, and keep current the knowledge needed for asset management. Encodes the relationship between measured signal and physical mechanism explicitly, retaining that portion of failure mode knowledge in a documented form rather than in individual recollection.
8.1 Plan and control operational processes including life cycle management, and treat risks identified under 6.1. Severity and trajectory data informs the utilization, maintenance, improvement, and renewal gates the clause covers.
8.3 Control externally provided processes, products, technologies and services. VIE supplies the service scope, performance requirements, data specification, and API interface control document a customer needs to bring the deployment under control.
9.1 Monitor, measure, analyze and evaluate asset and asset management system performance. Functions as continuous monitoring and measurement instrumentation for the transformer fleet, at asset and fleet level.
9.2 Conduct internal audits of the asset management system at planned intervals. Produces a continuous, retrievable, per-asset condition record. This is the clause where the evidence problem is most acute and where a continuous record is most directly useful.
9.3 Review asset management system performance, including risk and condition trends, at planned intervals. Fleet level severity distribution and trend reporting, formatted for the management review pack.
10.2 Address nonconformities and incidents, and take corrective action including cause analysis. Pre-event condition history supports cause analysis after an incident, replacing reconstruction from recollection with a measured record of the period leading up to it.
10.3 Establish processes for predictive actions that predict the future behavior of a parameter required to support decision-making, and determine optimal intervention points. Supplies the predicted parameter, its measured trajectory, and the physical basis for the intervention threshold. This is the clause continuous condition monitoring exists to satisfy.

Scope and boundaries

Two limits should be stated plainly, because a conformance argument that overstates its reach fails at the first audit.

VIE is a condition data source, not an asset management system. It does not satisfy the leadership, organizational, or governance requirements of Clauses 4, 5, and 10 on its own, and it does not author the SAMP, the asset management policy, or the asset management objectives. It supplies data those artifacts are built on.

VIE Technologies Inc. is not a certifying body. VIE does not audit or attest to a customer's ISO 55001 conformance. Any conformance statement is the customer's own to make, based on their complete asset management system.

A current integration limit

VIE does not integrate directly with SCADA, historian, or CMMS platforms. Data reaches the customer's asset management information system through the REST API. Under the 2014 edition this was a minor implementation detail. Under Clause 7.6, which asks for traceability between financial and non-financial data, it means the customer carries the integration work needed to close that link. VIE states this openly rather than leaving it to be discovered during a gap analysis.

Implementation path

Five steps, sequenced to follow a 2024 transition gap analysis.

  1. Establish the fleet condition baseline before writing the SAMP section on transformers. A Clause 6.2.1 artifact built on an age distribution will need rewriting once measured condition contradicts it, and it usually does.
  2. Write the Clause 4.5.2 decision criteria for transformer intervention explicitly, stating the parameter, the threshold, and the physical basis for the threshold. This is the document the internal auditor will ask for under 9.2.
  3. Take delivery of the data specification and register it as Clause 7.6 documented information. Confirm it covers units, sampling interval, uncertainty, sensor provenance, retention, and the asset identifier.
  4. Connect the REST API to the asset management information system, and establish the identifier link between condition records and the capital entries they support, to close the financial traceability requirement in 7.6.
  5. Define the Clause 10.3 predictive action process in writing: which parameter is predicted, over what horizon, with what confidence, and how the intervention point is derived. Then route severity and trajectory alerts into the Clause 8.1 planning cycle and the Clause 9.3 management review.

Conclusion

The 2014 edition of ISO 55001 could be satisfied by an organization that documented its intentions carefully. The 2024 edition asks for more. It asks what the decision framework is, what the criteria are, what the data specification says, and how a future condition is predicted. Those questions have measured answers or they have assumed ones.

For transformer fleets, continuous physics-based condition data supplies the measured answers to the clauses that ask for them, most directly 4.5, 7.6, and 10.3. It does not supply the governance the standard requires, and it does not certify anything. Positioned accurately, it is the layer that lets an asset management system's transformer decisions be defended by evidence rather than by convention.

Appendix A: Auditor evidence checklist

Take this into a Clause 9.2 internal audit or a 2024 transition gap analysis. The final column is the customer's own work in every row.

Clause What an Auditor Asks Evidence a Condition Record Supplies What the Organization Still Owes
4.5.2 On what basis is this unit rated at this severity? Measured signal, normalization, mechanism, failure mode, and derivation of the severity value. The written decision criteria document, and the authority who approved the thresholds.
6.1.2 How is likelihood of failure determined for a transformer? Per-unit condition and trajectory replacing an age proxy. The risk assessment process itself, including consequence and criticality scoring.
6.2.2 Is this asset management objective measurable and monitored? The continuous measurement stream the objective is tracked against. The objective as written, its target, and its owner.
7.6 Where is the specification for this data? Data specification per deployment: attributes, units, uncertainty, sources, retention, identifier. Registration as documented information, and the financial traceability link in the asset register.
8.1 How was the timing of this intervention planned and controlled? Severity and trajectory at the date of the decision, retrievable after the fact. The planning process, the approval record, and the resource allocation.
8.3 How is this external provider controlled and evaluated? Service scope, performance requirements, data specification, API interface control document. The evaluation criteria, the review cadence, and the evaluation records.
9.2 Show me the condition record for this asset over the audit period. Continuous, timestamped, per-asset, per-sensor record with no gaps to explain. The audit programme, auditor competence records, and the findings log.
10.3 Which parameter do you predict, and how do you set the intervention point? The parameter, its trajectory, and the physical relationship the threshold is derived from. The documented predictive action process and the reporting on long term effects of predictive actions.
